SMART OFFICE & HOME · CCB #249201 · MILWAUKIE, OR

One crew wires the whole connected office.

Wi‑Fi, cameras, access control and A/V all ride on the same low voltage backbone. We plan it, pull it, terminate it and label it — so your IT provider inherits a network that is documented, not a guess.

Wide interior data-room shot: yellow cable ladder trays feeding equipment racks on both sides of the aisle.

SECTION 01 / WHAT'S UNDER THE DESK

A smart office is four systems on one backbone.

Nobody buys "smart office" cable by itself. They buy a building where the Wi‑Fi reaches, the cameras record, the doors badge in and the conference room turns on — and one contractor is responsible for the wiring behind all four.

U01

Wired backbone

Cat6/6A runs to every closet and ceiling AP location, home-run to a labeled patch panel.

  • Cat6 / 6A
  • PoE
  • Patch & label
U02

Wi‑Fi & wireless

Access point cabling and placement planned around the floor plan, not just the ceiling grid.

  • AP drops
  • Coverage
U03

Cameras & access

Entry points, common areas and server rooms wired for cameras and badge readers on the same visit.

  • IP cameras
  • Access control
U04

Conference & A/V

Display, camera and audio runs to the conference rooms and common spaces, ready for your A/V gear.

  • Displays
  • Conferencing

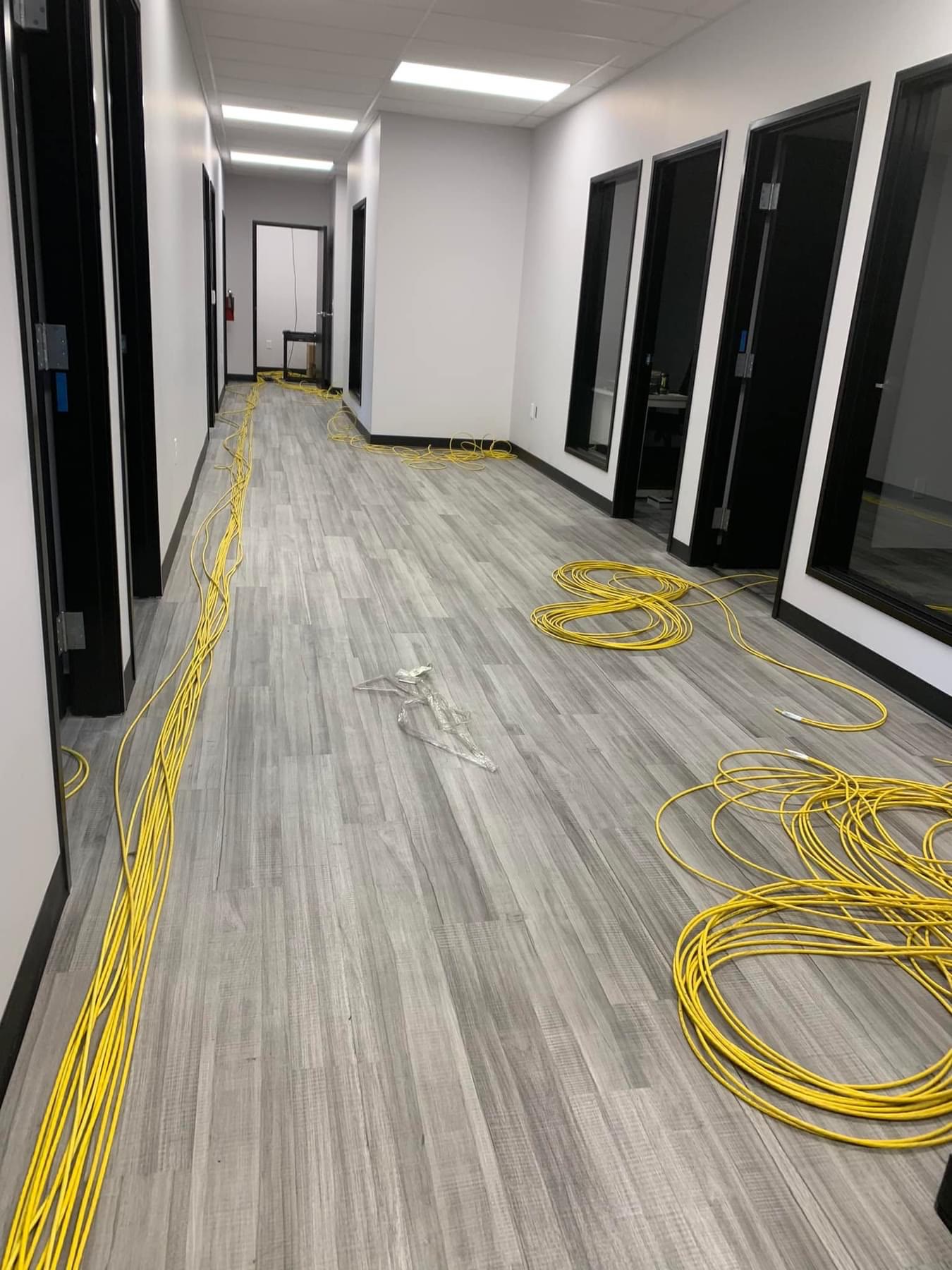

Office hallway mid-cabling: coiled yellow patch cable on the floor, glass-front offices along the hall.

SECTION 02 / ONE THROAT TO CHOKE

Four vendors on one office is how nobody owns the problem.

When the Wi‑Fi is slow in one corner, or a camera goes dark, or a badge reader stops reading, the first question is usually "whose cable is that." We would rather it always be a short conversation: it is ours, we pulled it, we know exactly where it runs.

Licensed crew, twenty-two years in the trade, one invoice for the cabling side of a connected building.

SECTION 03 / BUILDINGS THAT FIT

Any office with more than one closet.

SECTION 04 / READ THE LABEL

What's actually in the walls.

A "smart office" is a category most people can pull four systems into one cable plant. Here is roughly what each one needs — the walkthrough sets the real counts for your space.

Ask what your office needs →
SystemCarriesTypical run
Backbone / desksCat6 / Cat6ATo 100 m
Wi‑Fi access pointsPoE, Cat6Ceiling drops
CamerasPoE, Cat6Entry & common areas
Access controlLow-voltage, PoEPer door
A/V & conferencingHDBaseT, Cat6Conference rooms

General cable-plant reference — not a design for any specific office. TIA/EIA-568 categories.

SECTION 05 / WHY IT MATTERS

An undocumented office is a liability with a lease.

Every unlabeled cable is a future service call. Every access point nobody mapped is a coverage hole somebody discovers on a bad day. We hand over a record of what runs where — because the next person touching it is not always us.

SECTION 06 / HOW WE SCOPE IT

We walk the floor plan before we quote it.

Desk counts, AP placement, camera sightlines, door counts and where the IT closet actually is — not where the drawing says it is. That walkthrough is what turns "smart office" into a number you can compare against another bidder's.

Main distribution frame server room: cable ladder racks stacked with dressed bundles feeding equipment racks.

Behind the walls

Every office has one of these somewhere. We label it.

SECTION 07 / DUE DILIGENCE

Before you hire anybody for office wiring.

Four questions worth asking any bidder, including us.

  1. Is the technician actually licensed?Oregon CCB #249201 and electrical licence 4911LEA cover this work. Look up any contractor's licence before they touch a wall.
  2. Will you get a labeled patch map?A record of what port feeds what device, handed over at close-out — not held in someone's head.
  3. Who owns the network config afterward?Cabling and switch/network configuration are usually two different scopes. Ask where the line is drawn.
  4. Can the crew work around your business hours?Off-hours and weekend pulls in occupied offices are normal for us.

SECTION 08 / THE RUN

From floor plan to labeled panel.

One cable. Five stations.

  1. 01

    Walk the floor plan

    AP locations, camera sightlines, door counts, closet reality.

  2. 02

    Design the backbone

    Counts, routes, category, a number you can compare.

  3. 03

    Pull & mount

    Nights and weekends available so the office keeps running.

  4. 04

    Terminate & test

    Drops terminated and tested before handover.

  5. 05

    Label & hand over

    A patch map your IT provider can actually use.

SECTION 09 / THE OTHER TRADES

You bring the IT plan. We bring the cable.

IT managers

You own the switches, the SSIDs and the security policy. We get PoE and copper to exactly where you need it, terminated and labeled.

Office & facility leads

One contractor for the cabling behind Wi‑Fi, cameras, access control and A/V, instead of four separate vendors and four separate invoices.

General contractors

Tenant-improvement timelines, other trades on site, a schedule that is not ours alone. We are used to all three.

SECTION 10 / STARTING FROM SCRATCH, OR NOT

New build or an office nobody documented, both work.

Ground-up tenant improvement gets a clean backbone from day one. An office that grew its Wi‑Fi and cameras over ten years of "just add one more" gets a walkthrough first, so we know what is reusable before we quote anything.

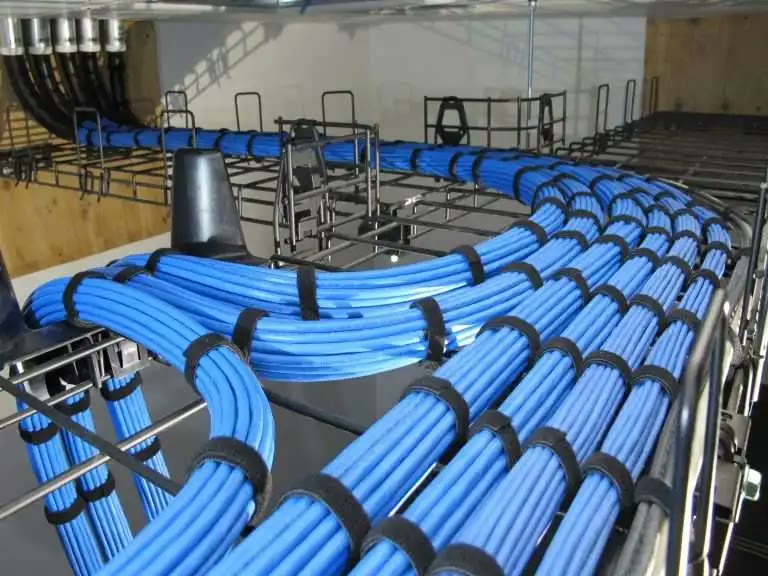

Overhead cable-tray shot: bundled blue runs across ladder rack under a wood-frame ceiling.

POWER BUDGET

The switch runs out of watts before it runs out of ports.

A smart office stacks access points, cameras, badge readers and desk phones onto the same PoE switches, and each device class draws a different wattage: 15.4W, 30W or up to 90W depending on class and standard. A 48-port switch rarely delivers full power to all 48 ports at once — it has a total power budget, checked against the sum of connected devices, not the port count on a spec sheet. Idle draw isn't the number that matters either. A camera's IR illuminators kick on at night and a door strike pulls current on every unlock, and once that real-world draw pushes total consumption past the switch's negotiated budget, the switch can refuse to power up the next device added or cut power to a port already running. That shows up as a camera that drops at night or an AP that reboots under load — read as a network problem when it's a power problem.

  • PoE classes802.3af draws 15.4W, 802.3at draws 30W, 802.3bt draws 60W to 90W — matched to what each device actually needs.
  • Spike drawCamera IR illuminators and electric strikes pull current well above idle.
  • Shared budgetThe switch checks total connected load against one power budget, not a per-port rating.
  • Over budgetThe switch can cut a port already running or refuse to power up the next device added.
  • Planning stepFull device wattage tallied before the switch is ordered, not after.

CEILING GRID

A ceiling grid runs out of clean tile before the device list runs out.

Every device we put in a ceiling — access point, camera, occupancy sensor, ceiling speaker — competes for the same tile as a sprinkler head, an HVAC diffuser, a light fixture and a fire strobe that another trade already claimed. An access point mounted next to a metal duct or a fluorescent ballast can lose signal to interference nobody sees until the walkthrough is long over. An occupancy sensor placed in the airflow of a diffuser trips lights on an empty room because moving air reads as motion. A camera sightline that worked on the drawing gets blocked the day the diffuser goes in six inches to the left of where it was drawn. None of this gets fixed with a ladder and a guess on install day — it gets marked on a reflected ceiling plan before rough-in, tile by tile, with every trade's device on it at once.

  • Reflected ceiling planEvery trade's device marked on it before rough-in starts.
  • AP clearanceKept clear of metal duct and light ballast to avoid RF shadowing.
  • Sensor placementOccupancy sensors kept out of diffuser airflow to avoid false triggers.
  • Camera sightlinesChecked against the as-installed diffuser and sprinkler layout, not the original drawing.
  • Tile conflictsSettled on paper before rough-in, not by whoever has a ladder up that day.

ROOM PROFILES

A huddle room and an open floor don't need less of the same hardware — they need different hardware.

Access point density gets set by how many devices will actually connect and pull bandwidth in a space at once, not by square footage alone — an open desking floor with forty laptops needs a different AP count than a storage room the same size. Wall material changes the math room to room: glass-walled conference rooms pass a WiFi signal differently than a block corridor or a stud wall packed with foil-backed insulation. Camera and audio needs shift the same way. A huddle room gets a wide-angle camera and a beamforming mic sized for a four-person table; a large conference room needs a ceiling mic array and more than one camera zone to cover a room that size properly. The room type sets the device list before the walkthrough number gets finalized.

  • AP densitySet by concurrent connected-device load, not raw square footage.
  • Wall materialGlass, block and foil-backed stud walls each attenuate WiFi differently, room to room.
  • Huddle roomWide-angle camera and a beamforming mic sized for a small table.
  • Large conference roomCeiling mic array plus multiple camera zones, not one webcam.
  • Cable countSet by room type before the walkthrough number is final.

IDF POWER

When the IDF loses power, WiFi, cameras, phones and doors all go dark at once.

Converging four systems onto shared PoE means the IDF's power decisions carry more weight than they would for any one of those systems alone. A UPS sized off the switch's nameplate rating instead of its actual connected load runs out of runtime faster than expected during an outage. Door hardware has to be decided per door, per code, as fail-safe — unlocking when power drops — or fail-secure, staying locked. Camera recording continuity during a short blip is a different design question than continuity through an extended outage. None of that is a detail to work out after the fact; it gets decided before drywall closes the IDF closet, documented the same way the rack itself is documented, so the next person who opens that closet knows what happens when the power goes.

  • UPS sizingRuntime sized to the actual connected PoE load, not the switch's nameplate rating.
  • Door hardwareDecided per door, per code: fail-safe unlocks on power loss, fail-secure stays locked.
  • Recording continuityA short blip and an extended outage are different design requirements for camera recording.
  • Uplink redundancySingle uplink path or a dual path to the core, decided for whichever systems the building treats as critical.
  • Switch redundancyA second switch or a single point of failure, decided separately from the uplink question.
  • DocumentationThe IDF's own power source documented alongside the rack it feeds.

CLOSEOUT RECORD

The closeout record has to cover four systems, not one cable schedule.

A patch map tells you what port feeds what jack. A smart office closeout has to go further, because the handoff covers cabling, WiFi, cameras and access control at once, and whoever inherits the building needs all four in one place. That means a cable schedule with an ID, origin, destination, category and length for every run; a rack elevation showing exactly which patch panel port lands where; an as-built floor plan with every access point, camera and card reader location redlined against the original design, not the drawing that was accurate on day one; a MAC-to-port map for whoever owns the switch configuration; and the cable certification results — wire map, length, insertion loss — kept per run instead of spot-checked. The four records also have to agree with each other: the same patch-panel port has to match across the cable schedule, the MAC-to-port map and the as-built floor plan, and a mismatch there is a failure a single-system schedule never has to catch. Missing any one of these turns a documented building back into a guess the first time something needs troubleshooting.

  • Cable scheduleID, origin, destination, category, length and test result, one row per run.
  • Rack elevationShows exactly which patch panel port lands where.
  • As-built floor planAP, camera and card-reader locations redlined against the original design.
  • MAC-to-port mapHanded to whoever owns the switch and network configuration.
  • Certification resultsWire map, length and insertion loss kept per run, not spot-checked.
  • Cross-checkThe same patch-panel port has to match across the cable schedule, the MAC map and the floor plan.

ROUGH-IN WINDOW

Miss the ceiling close-in and an overhead pull becomes a fished wall.

Low-voltage rough-in for a smart office has to land inside a narrow window on a tenant improvement schedule: after wall framing goes up but before drywall closes the stud bay, and after duct and sprinkler rough-in above the ceiling but before the grid and tile go in. Miss either window and a run that should have been a clean overhead pull to a patch panel turns into a fished wall or a surface raceway nobody wanted on the finished space. Floor boxes carry their own timing problem — the low-voltage whip inside one has to be roughed in before the slab pour or before an underfloor duct system closes, which puts that decision against the concrete schedule, not the furniture delivery date. A power pole runs the opposite direction: its whip drops from the ceiling grid or plenum, so it follows the above-ceiling rough-in window instead of the slab. Coordinating with the general contractor's trade sequence is how both windows get hit instead of missed.

  • Wall rough-inAfter framing, before drywall closes the stud bay.
  • Above-ceiling rough-inAfter duct and sprinkler rough-in, before grid and tile go in.
  • Floor-box whipsRoughed in before the slab pour or before an underfloor duct system closes.
  • Power-pole whipsDropped from the ceiling grid or plenum, timed to the above-ceiling window, not the slab.
  • Missed windowTurns a clean overhead pull into a fished wall or a surface raceway.
  • SequencingSet against the general contractor's trade schedule, not worked around after the fact.

WIRELESS COVERAGE

Coverage drawn on a floor plan and coverage where people actually sit are different maps.

An access point count that looks right on a floor plan can still leave a corner of an open desking floor thin, because the design has to account for concurrent client load and call traffic at each AP, not just square footage divided evenly. Wall material changes the picture room to room — glass, block and foil-backed insulation each attenuate the 2.4, 5 and 6GHz bands differently, and a floor plan drawing doesn't show which walls have foil in them. Space APs too close together on an open floor and they compete on the same channel instead of covering more ground. None of this gets confirmed by a signed-off drawing; it gets confirmed by walking the finished space with the furniture, whiteboards and filing cabinets actually in it, checking real signal against the design instead of the plan.

  • AP densityDriven by concurrent client and call load, not square footage divided evenly.
  • Wall attenuationGlass, block and foil-backed insulation each block WiFi differently, wall to wall.
  • Co-channel interferenceRisk when APs are spaced too tightly on an open floor.
  • Band behavior2.4, 5 and 6GHz bands pass through the same wall differently — the design accounts for all three.
  • Post-install walkSignal checked against the as-built space with furniture in it, not just a signed-off drawing.

SECTION 11 / LICENSED, BONDED, INSURED

The numbers you're supposed to ask for.

Verify any of them before you hire anybody, including us.

On file, and checkable

Oregon CCB#249201
VERIFIED
Oregon electrical4911LEA
VERIFIED
Liability insurance$2,000,000
VERIFIED
Bond$50,000
VERIFIED
ccblookup.comCCB checked 8 Sep 2026

SECTION 12 / BEFORE YOU CALL

Straight answers.

What counts as a "smart office" job for you?

The low-voltage backbone underneath a connected office: cabling for Wi‑Fi access points, cameras, access control and A/V, all pulled, terminated and labeled by one crew instead of four separate vendors.

Do you work in occupied, running offices?

Yes. We're on call 24/7 — off-hours or weekend work in an occupied building is normal for us.

Do you configure the network, or just install the cabling?

We pull, terminate and certify the physical cabling. Switch and network configuration is typically your IT provider's side of the line, and we coordinate with them directly.

Can you take over office wiring someone else started?

Often, yes. We walk the site first and tell you what is reusable before quoting anything.

Are you licensed for this work?

We hold Oregon CCB #249201, Oregon electrical licence 4911LEA, CLE723 and Washington licence KNEPPJK854KK, with $2,000,000 in liability insurance and a $50,000 bond.

How do I get a quote?

Book a walkthrough. We look at the space, then you get a written scope and price you can compare against anyone else's.

SECTION 13 / NEXT STEP

One backbone. Every system on it.

Licensed, bonded and insured · 5.0★ on Google, 18 reviews · 24/7 on call from Milwaukie, OR.

Move your cursor across this band

Call (971) 419-8917 Book
